DICE
Is your project likely to
 succeed or fail?

Successful Project Management is about identifying likely points of failure and putting in place contingency plans to ensure delivery.

Wouldn’t it be good if you could have a tool which was able to measure the likelyhood of your projects success.

Key elements that will dictate whether your project will be a success or failure.

DICE is based on a 100+ large projects

> Step functions for each element of DICE* were established

> 225 change projects from throughout the world were surveyed

> DICE was converted into a simple mathematical formula to predict   likelihood, and allow manipulation of outcomes PRIOR TO IMPLEMENTATION

> Plotting results reinforces DICE

      ●It becomes possible to define zones of behaviour into which projects can be pushed

      ●Specific conditions can be defined to select for success (or failure) in a quantifiable way






Reflection



If you had this tool (DICE) up front, would you have managed your project differently ?





…….. or are you prepared to gamble?

D uration

The timeline until either completion of the project or the next learning milestone

The ‘learning milestone’ is a predetermined stage in implementation at which project strengths,  weaknesses and progress against key performance measures are formally assessed

Duration of change either to completion or ‘learning milestone’

Score; 1. <2 months, 2. 2-4 months, 3. 4-8 months, 4. >8 months

I ntegrity

The performance integrity of the project team

Attributes portfolio includes:  fast track individuals, challenging minds, people skills, team playing, self motivation, appropriate resources, pushing to conclusion, hardworking and organising skills

Performance integrity of project team

Score;   1. Very good, 2. Good, 3. Average, 4. Poor

C ommitment

The commitment to the change

This includes the attitudes of both the local area undergoing the change (C2) and the visible as well as real commitment of relevant senior management (C1)

Commitment (1): Senior management commitment to the change

Score;  1. Clearly communicate need, 2. Seem to want success, 3. Neutral,                   4. Reluctant

Commitment (2); Local commitment to the change

Score;  1. Eager, 2. Willing, 3. Reluctant, 4. Strongly reluctant

E ffort

The additional amount of local effort (to normal working requirements) required during implementation

Local effort during implementation

Score; 1. <10% additional, 2. 10-20% additional, 4. 20-40% additional,                          5.  >40% additional

The Result

A Simple Formula To Predict, And Allow

 Manipulation Of, Outcome

DICE = D + 2I + 2C1 + C2 + E

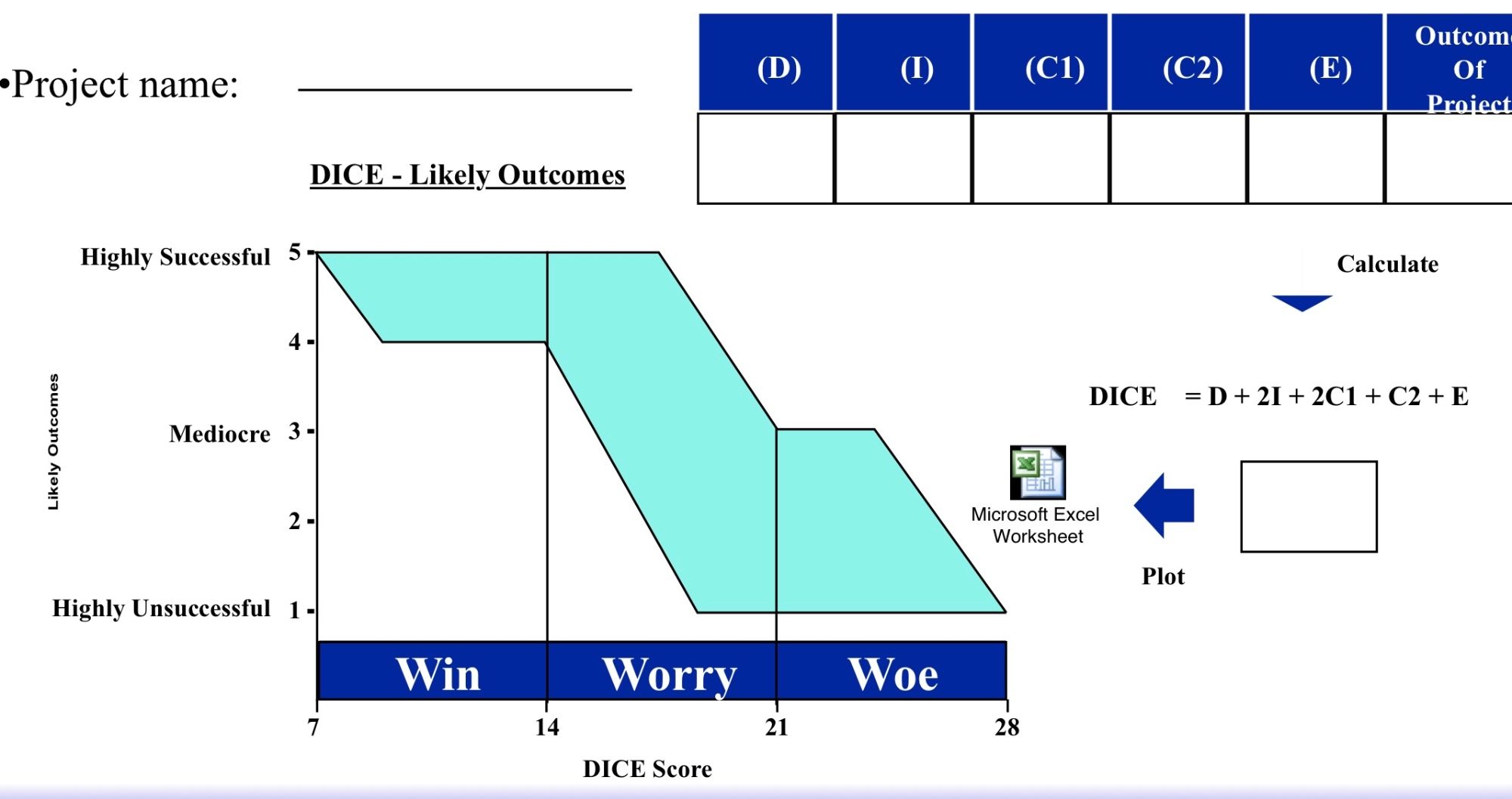

Calculate your own DICE

Pick a change related project you are       familiar with

Using the scoresheet, allocate scores for   D, I, C, E and the project outcome (if you know it) then calculate the DICE* score and plot it!
